FF&E Logistics & White-Glove Installation for Designers, Developers & Hotels

Receiving, warehousing, inventory management, quality-control inspection, project delivery and professional installation run through one coordinated operation, with a single team accountable from inbound freight to final placement.

  • Flat-rate project pricing
  • WarePulse inventory visibility
  • Formal OS&D controls
  • White-glove installation
  • National large-project capability

Local service calls across the Greater Montreal Area, and coordinated FF&E programs in major Canadian markets.

Before the logistics phase

Need us to source the FF&E too?

If your furniture package still needs design coordination, manufacturer sourcing, purchasing or supply, start with FF&E procurement and furnishing. Logistics covers receiving, warehousing, delivery and installation once that scope is ready.

Explore FF&E Procurement & Furnishing

What FF&E logistics actually includes

FF&E stands for furniture, fixtures and equipment: the loose and installed goods that turn a finished building into a working hotel, residence, office or retail space.

FF&E logistics is the discipline of moving those goods from the factory or freight forwarder to their final installed position without losing track of what arrived, what condition it arrived in, where it is stored and when it is needed on site. In practice that means inbound freight and container receiving, reconciliation against packing lists and purchase orders, condition documentation, warehousing, inventory control, room and floor allocation, sequenced delivery, assembly, placement and packaging removal.

Next Movement runs that full chain as one operation. Merchandise can be received from containers, trailers and skids, recorded into WarePulse, held in warehouse storage for as long as the schedule requires, then picked, staged, delivered and installed by crews that already know the inventory. Receiving, warehousing, delivery and installation are managed under one Next Movement project structure, one inventory record and one accountable operating plan, so an exception found on the dock stays attached to the record the installation crew works from months later.

This page is written for the questions professional project teams normally have to ask by email: what gets inspected, what it costs, how damage is handled, who sees the inventory, how crews present on site, how far in advance a program should be booked, and how pricing is built.

Built for professional project teams

The same operating chain is presented differently depending on who is accountable for the project.

Interior designers

Placement executed against your renders, floor plans and furniture schedules, with client-facing professionalism on site.

  • Placement from renders, floor plans and furniture schedules
  • Room and unit allocation held against the project inventory
  • High-value and designer pieces handled under project-specific instructions
  • Neutral, unbranded crew presentation available on request
  • Deficiencies documented and escalated rather than improvised

Developers

Phased openings, model suites and completion schedules supported without disturbing finished work.

  • Phased and floor-by-floor delivery sequencing
  • Model suites installed ahead of the main program
  • Finished-surface protection through occupied and completed areas
  • Multi-floor coordination with elevators and loading access
  • Storage held between construction milestones

General contractors

FF&E delivery planned around the construction schedule instead of competing with it.

  • Delivery windows planned against the construction schedule
  • Loading dock, hoist and elevator booking coordination
  • Milestone-driven mobilization by area or floor
  • Trade coordination so installation follows finishes
  • Night and weekend work supported where required and scheduled

Hotels & hospitality

Guest-room programs from decommissioning of existing furniture through to guest-ready rooms.

  • Decommissioning and disposal of existing room furniture
  • Receiving and warehousing ahead of the installation window
  • Allocation by room type, floor and guest-room number
  • Sequenced delivery and in-room assembly
  • Packaging and debris removal plus punch-list support

Procurement & FF&E teams

Documentation that reconciles against the paperwork your side of the project already runs on.

  • Reconciliation against packing lists and purchase-order references
  • SKU and article-number identification at receiving
  • Inbound documentation retained with the inventory record
  • Selectable inspection depth by vendor, SKU or shipment
  • Release controls so nothing ships before it is authorized

The full FF&E lifecycle, end to end

Inbound shipment through receiving, quality control, inventory, warehousing, allocation, delivery, installation, deficiency management and packaging removal.

  1. Inbound shipment

    Containers, trailers and skid shipments are scheduled into a receiving window with the vendor, freight forwarder or carrier so dock time and labour are planned rather than improvised.

  2. Receiving

    The shipment is verified against its reference, quantities are reconciled against the packing list and purchase-order information, SKU and article numbers are identified, and external condition is documented.

  3. Quality control and OS&D

    Standard receiving documents visible external condition. Enhanced quality control opens cartons and inspects the merchandise itself. Overages, shortages and damages are documented and escalated for disposition.

  4. WarePulse inventory

    Merchandise is recorded into WarePulse with quantities, SKU or article references, warehouse location, condition records and any holds so the project inventory is a live record rather than a spreadsheet.

  5. Warehousing

    Goods are stored for the project duration. For major programs, dedicated project capacity is planned, selected and prepared before the first container is authorized, so the footprint matches the contract rather than whatever space happens to be free.

  6. Pick and room allocation

    Inventory is allocated by room, unit, floor, room type or project phase, then picked and labelled so each truckload matches the sequence the installation crew will work in.

  7. Load and delivery

    Loads are built for the delivery sequence and moved to the installation site inside the agreed window, coordinated with the dock, hoist, elevator or access constraints of the building.

  8. White-glove installation

    Crews unload, unpack, assemble and place merchandise according to plans, renders or designer direction, then complete final positioning room by room.

  9. Deficiency and punch-list management

    Missing components, finish defects and damage found during installation are documented and escalated so the project team can decide on disposition rather than discovering it at handover.

  10. Packaging and cleanup

    Cartons, blankets, protective wrap and debris are consolidated and removed so the room or floor is left in the condition the schedule requires.

A project can enter this chain at any point. Some clients ask for receiving and warehousing only; others hand over the full sequence from inbound container to guest-ready room.

WarePulse: the inventory record behind the project

WarePulse is Next Movement’s own warehouse and inventory management platform. It is the system the warehouse actually runs on, and it is what gives a project team visibility into its own merchandise.

Most FF&E problems are information problems. A piece is missing, or it is damaged, or nobody can say whether it was ever received, and the answer lives in somebody’s inbox. WarePulse exists so the answer lives against the inventory record instead.

Receiving records, condition records, quantities, warehouse locations, holds, exception records, staging status and outbound status are all attached to the same inventory. When the installation crew picks a room, they are picking against the same record the receiving team created months earlier.

The screens the work actually runs on

Inbound receipts

The receipts workspace where inbound purchase orders and dock activity are worked, so a container is reconciled against its documentation as it is unloaded.

WarePulse receipts screen with inbound purchase orders and dock activity

Damage and exception capture

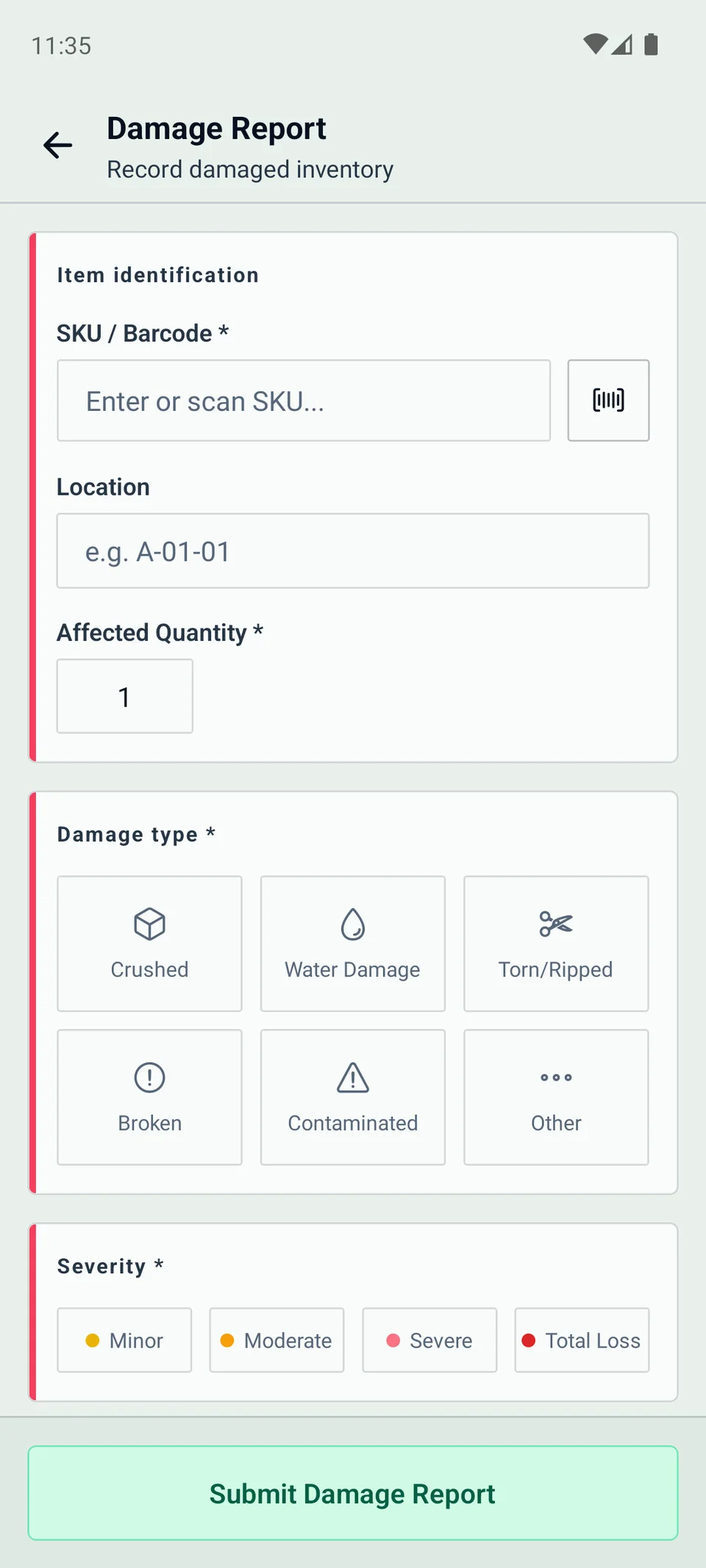

Damage reporting captured in the warehouse app with notes and photo evidence, which is how an OS&D exception gets attached to the inventory record at the moment it is found.

WarePulse mobile app damage report workflow with notes and photo evidence

Operator inventory control

The operator inventory screen with stock controls and visible balances, used to confirm what is on hand, where it is located and what is already allocated.

WarePulse operator inventory portal with stock controls and visible balances

Pick execution

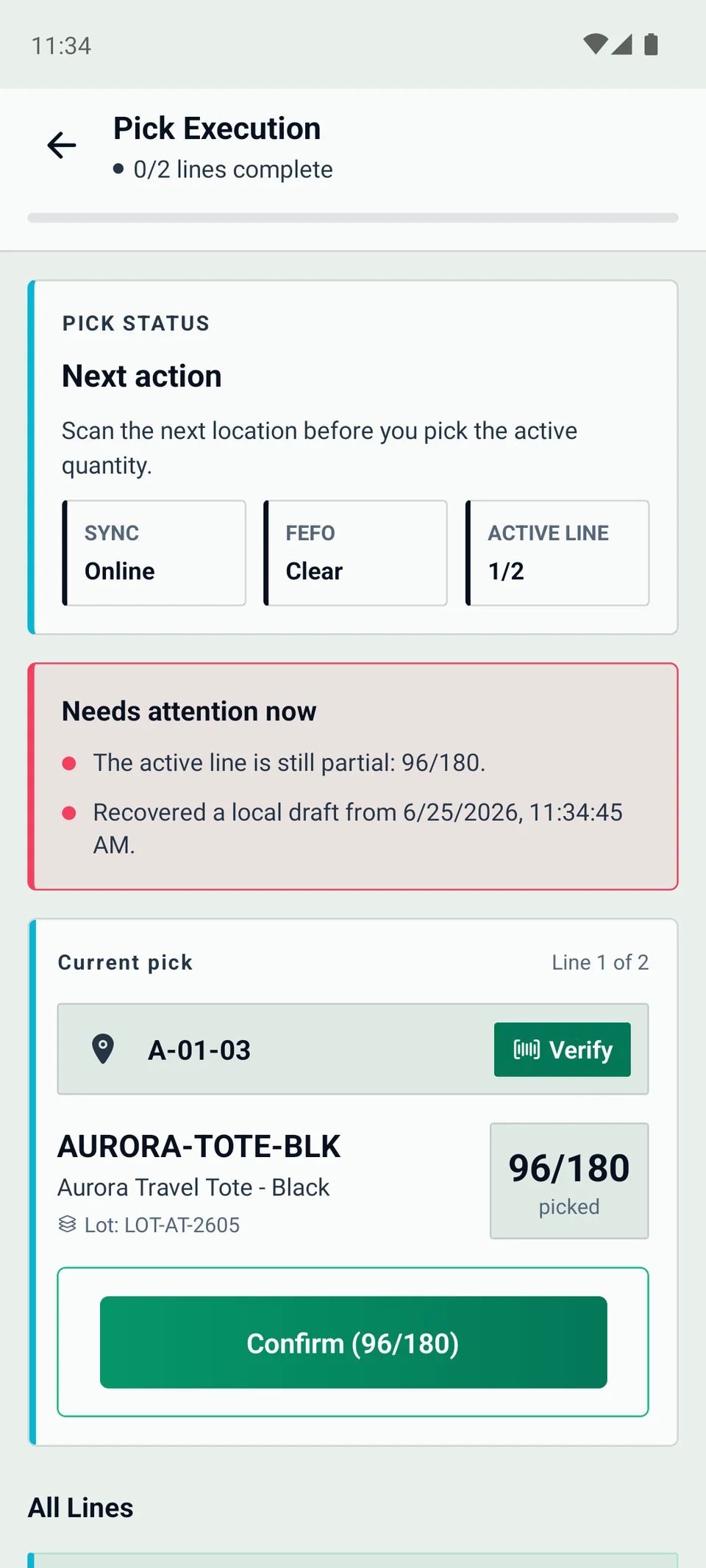

Pick execution with active line progress, used when a room, floor or phase is being pulled for a delivery run.

WarePulse mobile app pick execution screen with active line progress

Client-side inventory portal

The customer inventory portal showing stock, allocation and available units, which is the surface a project team can be given access to rather than the internal console.

WarePulse customer inventory portal showing stock, allocation, and available units

Client-side control tower

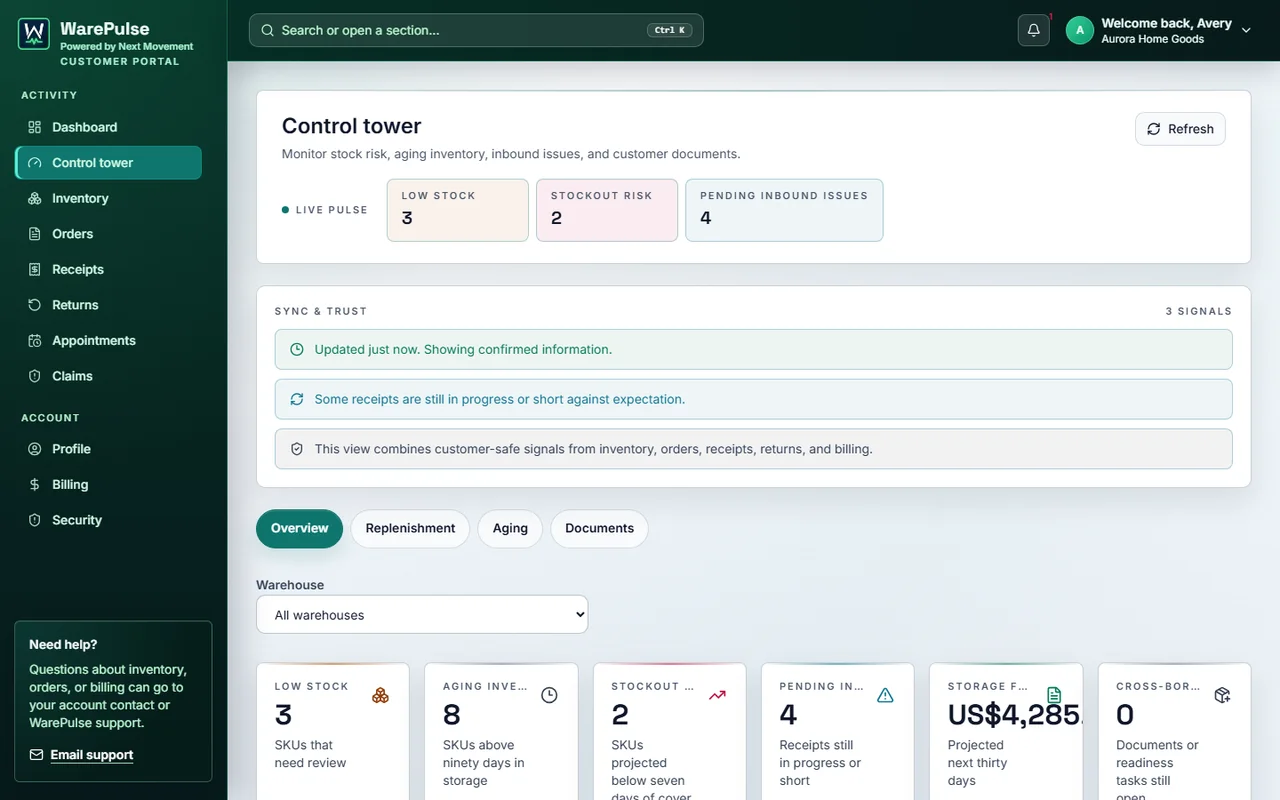

The customer control tower with order visibility and warehouse service status, so the project side can see progress without asking for a status report.

WarePulse customer control tower showing order visibility and warehouse service status

Standard receiving vs. enhanced FF&E quality control

Two different depths of inspection, priced differently, selectable per project, per vendor or per SKU.

Standard receiving

The baseline record every shipment gets: what arrived, how much of it arrived, and what the outside of it looked like on arrival.

Included in project receiving rates

Per container, trailer or skid

  • Verify the shipment against its reference
  • Reconcile quantities against packing list and purchase-order information
  • Identify SKU and article numbers
  • Document external condition
  • Photograph visible irregularities or damage
  • Record merchandise into WarePulse
  • Assign a warehouse location
  • Putaway and staging

Enhanced receiving / quality control

Cartons are opened and the merchandise itself is inspected, within the inspection scope approved for the project.

Customer-facing rate

$35 per labour-hour

  • Open cartons
  • Visually inspect the merchandise itself
  • Identify visible finish defects
  • Identify visible damage
  • Check for obvious missing components or hardware where practical
  • Photograph findings
  • Document deficiencies
  • Repack where appropriate
  • Place affected goods on hold or in quarantine
  • Escalate for client disposition

Choose the inspection depth, not a single blanket policy

Enhanced quality control is billed at $35 per labour-hour. That is the customer-facing rate, and it is the one exception to the flat-rate project model used elsewhere on this page, because inspection time depends on what is actually inside the cartons.

Because it is hourly, inspection depth can be selected by project, by vendor or by SKU instead of automatically paying for full open-box inspection of every incoming piece. A common pattern is full open-box inspection on a vendor with a known quality history or on high-value case goods, and standard receiving on commodity items.

Enhanced quality control is a visual inspection of the merchandise within the approved scope. It is not destructive testing and it is not a manufacturer-grade quality certification.

What each receiving level covers

Receiving activityStandard receivingEnhanced QC
Shipment verified against its referenceIncludedIncluded
Quantities reconciled against packing list and PO informationIncludedIncluded
SKU / article numbers identifiedIncludedIncluded
External carton condition documentedIncludedIncluded
Visible irregularities photographedIncludedIncluded
Recorded into WarePulse and assigned a locationIncludedIncluded
Cartons openedNot includedIncluded
Merchandise itself visually inspectedNot includedIncluded
Visible finish defects identifiedNot includedIncluded
Obvious missing components checked where practicalNot includedIncluded
Deficiencies documented and photographedExternal onlyIncluded
Affected goods placed on hold or quarantinedOn requestIncluded

OS&D: overages, shortages and damages

A documented exception process so a receiving problem is resolved before it becomes an installation problem.

OS&D stands for overages, shortages and damages. It is the umbrella term for anything that does not match what the paperwork said should arrive, or that arrives in a condition the project cannot accept.

  1. Document

    The exception is written down against the shipment: what was expected, what actually arrived, and how the two differ.

  2. Photograph

    Visual evidence is captured at the point the exception is found, while the packaging and shipment context are still intact.

  3. Record

    The exception is recorded against the inventory record in WarePulse so it travels with the merchandise instead of living in an email thread.

  4. Hold / isolate

    Affected merchandise can be isolated or placed on hold so it does not accidentally proceed to outbound delivery or installation before the exception is resolved.

  5. Notify

    The project contact is notified with the documentation attached so the decision is made with evidence rather than description.

  6. Authorized disposition

    The merchandise moves only once an authorized decision is made: release, repair, return, replace or hold pending vendor response.

Isolating affected merchandise is the operationally important step. Once a piece is on hold in WarePulse it is not picked into an outbound load by mistake, which is how damaged goods normally end up discovered in a guest room instead of on a dock.

Why chain-of-custody documentation matters

Documented receiving and condition records help distinguish between causes that would otherwise be argued about after the fact:

  • Freight or carrier damage in transit
  • Manufacturing or product deficiencies
  • Shortages against the shipping documentation
  • Incorrect product supplied against the order
  • Warehouse-handling events
  • Installation-related events on site

Documentation supports a claim; it does not decide one. Next Movement does not guarantee claim approval or the assignment of liability by a carrier, vendor or insurer.

Project-specific warehousing for major FF&E programs

An additional capacity strategy for large programs, alongside Next Movement’s existing warehousing and storage operations.

Next Movement provides warehousing and storage as part of its FF&E operations. For major programs requiring substantial dedicated contiguous capacity, additional project-specific warehouse capacity can also be selected around the requirements of the project. A full-property guest-room program can call for roughly 8,000 to 25,000+ square feet of contiguous space over a limited project period, with an inbound container schedule that fills it quickly.

At that scale, capacity is planned rather than assumed. Space is selected against the requirements of the contract — footprint, inbound schedule, dock and equipment needs, operating hours, security, insurance and proximity to the installation site — and the facility is then prepared before merchandise is authorized to ship to it.

This is a normal feature of warehousing economics. Large programs can require substantial contiguous capacity that may not align with normal residual warehouse availability, so the practical way to give a major program the footprint it needs is to plan facility requirements around the actual contract and its duration.

A permanent warehouse address is not the same thing as guaranteed project capacity. A facility is useful only if the required capacity is actually available, prepared and controlled when the inventory arrives — which is what the warehouse-readiness process below establishes.

Two ways project capacity is provided

We plan the warehouse around the project rather than asking the project to fit whatever capacity happens to remain available.

Warehousing and storage operations

Warehousing, storage and cross-docking provided as part of Next Movement’s FF&E operations, covering receiving, staging and project inventory work.

  • Receiving, putaway and staging
  • Short- and long-term project storage
  • Inventory recorded and tracked in WarePulse

Dedicated project capacity

Additional contiguous capacity secured for the duration of a major FF&E program when the footprint justifies it.

  • Roughly 8,000 to 25,000+ sq. ft. contiguous where required
  • Selected against dock, equipment, security and insurance requirements
  • Planned around the project duration and inbound schedule

Proximity to the installation site

Where it changes the delivery plan, capacity can be sourced closer to the installation site to shorten each delivery run.

  • Shorter delivery runs during the installation window
  • Easier re-sequencing when the site schedule moves
  • Less exposure to long-haul transfers mid-project

Warehousing and storage are part of Next Movement’s FF&E operations, and project-specific capacity can be added on top of them when a program requires it.

See storage and warehousing services

Pre-mobilization control

Warehouse readiness and facility approval

How the project footprint is sized, how a facility is selected and prepared, where your team can review it, and what has to be complete before the first container is authorized to ship.

A permanent warehouse address is not the same thing as guaranteed project capacity, because a permanent warehouse may already be substantially occupied. For major FF&E programs, warehouse selection is therefore handled as a pre-mobilization milestone rather than an assumption: capacity is planned, a facility is selected against the requirements of the project, readiness is completed, and only then is inbound merchandise directed to it.

The nine stages below are the sequence a major program runs through. Smaller scopes handled inside existing warehousing use the same controls in a shorter form, because the project structure, the inventory setup and the receiving zones still have to exist before merchandise arrives.

The readiness sequence

  1. Project capacity assessment

    Inventory volume, required square footage, inbound volume, container and trailer schedule, storage duration, installation schedule, staging requirement, project phases and outbound intensity are estimated from the project data you supply, so the footprint is a calculation rather than a guess.

  2. Facility requirements defined

    The assessment becomes written facility requirements: contiguous usable footprint, dock and loading access, trailer and container receiving, ceiling and racking, material-handling equipment, staging, proximity, operating hours, and the security, fire, building and insurance conditions that apply to the project.

  3. Suitable capacity identified

    Capacity is identified against those requirements in the relevant market. For programs needing substantial dedicated space, that means selecting capacity for the project rather than forcing the project into whatever residual space happens to be available.

  4. Facility and operating requirements reviewed

    Candidate capacity is reviewed against the written requirements: access and dock configuration, equipment, staging, operating hours, and the security, fire-protection, building and insurance conditions applicable to that specific facility. Requirements are confirmed for the facility being selected rather than assumed from a general description.

  5. Project facility selected

    One facility is selected for the project and confirmed for the project term, with the operating arrangements, access conditions and cost basis set out in the project documentation.

  6. Client review where requested

    Where requested and commercially appropriate, the selected facility can be reviewed by your team, and a visit can be arranged by appointment subject to facility and security requirements. Readiness expectations can be discussed before first receipt.

  7. WarePulse project setup

    The project is created and configured in WarePulse before receiving begins: inventory structure, receiving references, location structure, quality-control requirements, OS&D workflow, hold and exception handling, and staging and outbound conventions.

  8. Receiving and staging zones prepared

    The physical layout is set up to match the system: receiving zone, quality-control area, hold and OS&D area, putaway locations, staging and outbound lanes, with dock scheduling and material-handling equipment confirmed against the inbound schedule.

  9. Inbound merchandise authorized

    Only once the readiness controls are complete is inbound merchandise authorized to the selected facility, with the receiving window, shipment references and escalation contacts confirmed with the vendor, freight forwarder or carrier.

What the capacity assessment estimates

Sizing comes from the project, so the more of this you can supply at intake, the closer the footprint and the schedule are to the real thing.

  • Inventory volume and composition
  • Required square footage
  • Inbound volume
  • Container and trailer schedule
  • Storage duration
  • Installation schedule
  • Staging requirement
  • Project phases
  • Outbound intensity during the installation window

What the facility requirements cover

Requirements are written before capacity is sought, and each is evaluated where it applies to the project.

  • Contiguous usable footprint
  • Dock and loading access
  • Trailer and container receiving
  • Ceiling height and racking requirements
  • Material-handling equipment
  • Staging area
  • Proximity to the project site
  • Operating hours
  • Security requirements
  • Fire and building requirements
  • Insurance requirements
  • Site accessibility

Security, fire-protection and insurance characteristics are confirmed for the facility actually selected and recorded in the project documentation. They are not claimed generically ahead of that selection.

Client review as a project milestone

For major FF&E programs, warehouse selection can be treated as a pre-mobilization project milestone. Where requested, the selected facility may be reviewed before inbound merchandise begins arriving.

  • The selected project facility can be reviewed by your team where requested
  • A facility visit can be arranged by appointment, subject to facility and security requirements
  • Readiness requirements can be discussed and agreed before first receipt
  • Facility-review requirements can be recorded at intake and built into the pre-mobilization schedule

Facility access is by appointment and remains subject to the requirements of the facility, its owner or operator, and applicable health, safety and security rules. Unrestricted access is not offered.

What is configured in WarePulse before receiving

System readiness is part of warehouse readiness. A receiving team cannot record an exception cleanly against a project that has not been set up.

  • Project created and configured
  • Inventory structure prepared
  • Receiving references prepared
  • Location structure prepared
  • Quality-control requirements established
  • OS&D workflow established
  • Hold and exception handling established
  • Staging and outbound conventions prepared

Inbound authorization

Project inventory should not be directed to the selected facility until the required warehouse-readiness controls have been completed.

That is an operating principle for how the project is run. Contractual acceptance, title and risk of loss remain governed by the applicable project agreement and by the terms of sale and carriage.

Included in a standard installation scope

Installation is the part of an FF&E program most often described vaguely. This is the scope Next Movement crews perform under an approved installation scope. What white-glove FF&E installation means here

  • Unloading and project delivery to the installation area

  • Unpacking

  • Furniture assembly

  • Placement according to floor plans

  • Placement according to designer direction

  • Floor-plan and room-type execution

  • Render-guided placement

  • Beds

  • Desks

  • Casegoods

  • Seating

  • Standard artwork

  • Standard mirrors

  • Accessories

  • Miscellaneous non-licensed fixtures

  • Final positioning

  • Packaging consolidation and removal

  • Room and floor punch-list support

Work that needs separate review, pricing or licensed trades

Some scope sits outside a standard installation crew. It is not refused, but it is reviewed, priced and staffed separately rather than absorbed silently into an installation day: Where a scope requires a licensed trade, it is identified during project review so the right trade is engaged. Next Movement does not represent itself as performing licensed electrical or plumbing work.

  • Electrical work

  • Plumbing work

  • Structural modification

  • Specialty rigging

  • Unusually heavy pieces

  • Marble and stone

  • Industrial carpet rolls

  • Crane work

  • Heavy forklift requirements

  • Unusual access conditions

High-value and designer FF&E

Specified designer pieces, custom case goods and high-value furniture are handled under project-specific instructions rather than a generic handling standard.

On a designer-specified project, a single chair or console can carry more replacement exposure than an entire truckload of commodity furniture, and the lead time to replace it can be measured in months. That changes how it should be received, stored, released and installed.

Handling requirements for high-value merchandise are agreed during project onboarding and then applied consistently, so the crew that unloads it and the crew that installs it are working from the same instructions.

Coverage is confirmed in writing for each project. Next Movement does not offer unlimited insurance coverage, and any coverage limits or declared-value arrangements are set out in the applicable quotation and insurance documentation.

Protecting finished surfaces on site

On an FF&E installation the building is usually already finished. Damage to a completed corridor costs more to remedy than the piece being carried through it. The operating principle: If a site condition creates a meaningful risk of damage, the crew escalates the condition rather than improvising simply to maintain production. Stopping to get a decision costs an hour; carrying a case good through an unprotected doorway to stay on schedule can cost a corridor.

  • Floor protection through delivery and installation routes

  • Protective runners where appropriate

  • Padding and moving blankets on contact surfaces

  • Door and corner protection on access routes

  • Furniture protection during staging and placement

  • Careful work around finished millwork

  • Documentation of sensitive or pre-existing conditions where appropriate

Crew presentation and professional conduct

On a designer-led or hospitality project, the crew is part of the client experience, not just the labour.

Next Movement branded

Crews arrive in Next Movement branded presentation, which is the default for most commercial and construction-site work.

  • Clear identification on site and at the loading dock
  • Straightforward for building security and dock coordination
  • Standard for general contractor and developer environments

Neutral / unbranded

Crews can instead arrive professionally dressed in neutral, unbranded attire when the project calls for it.

  • Useful when the crew is expected to operate as a neutral extension of the design or project team
  • Appropriate for client-facing reveals, model suites and occupied properties
  • Requested at project onboarding and applied consistently through the program

Conduct on site

Consistent professional conduct in occupied, client-facing and guest-facing environments.

  • Site rules, access procedures and quiet hours respected
  • Site-photography restrictions respected
  • Issues escalated to the project contact rather than improvised on the floor

Tools and proprietary hardware

Crews bring standard professional installation tools and equipment for the approved scope of work. Manufacturer-specific or proprietary brackets, hardware and components should accompany the merchandise. Where a proprietary component is missing, it is documented and escalated rather than substituting or modifying high-value furniture without authorization. Not every specialty tool for every manufacturer can be guaranteed on site; unusual requirements are identified during project review.

  • Standard assembly and installation hand tools

  • Cordless power tools for standard furniture assembly

  • Standard levelling, measuring and layout tools

  • Protective materials for floors, doors and corners

  • Standard material-handling equipment for the approved scope

From one installer to multi-shift project teams

Crew size is a planning input, not a fixed offering. The same operation covers a single service call and a phased program running several crews at once.

1

Single installer

One installer for a service call, a warranty replacement, a model-suite adjustment or a small punch-list visit, subject to availability.

2

Small crew

A two- to four-person crew for a floor, a set of units or a single-day installation block.

3

Multiple coordinated crews

Several crews working different floors or areas in parallel against one delivery sequence and one inventory record.

4

Large multi-shift project teams

Multi-shift teams for a full-property program, with labour planned in advance against project milestones.

How large-project labour is planned

Crew scale is confirmed against the project schedule during quoting. Availability at a specific date is subject to confirmation.

  • Labour is planned in advance rather than assembled on the day

  • Crews are coordinated across project phases

  • Day, night and weekend work can be supported where required and scheduled

  • Additional resources can be reserved against project milestones

  • Delivery sequence and crew allocation are planned together, not separately

Flat-rate project pricing, not open-ended hourly billing

With the single exception of enhanced receiving and quality control, defined FF&E projects are generally quoted on a flat-rate project basis.

Hourly billing on a large installation transfers all schedule risk to the client. Every access problem, every re-sequenced floor and every slow elevator becomes a line on an invoice, and the total is only known once the work is finished.

A defined FF&E scope is quoted as a project instead. Scope, inventory, sequence and site conditions are established before execution, and the price is built against that scope. Enhanced quality control remains hourly at $35 per labour-hour, because inspection time genuinely depends on what is inside the cartons and cannot honestly be fixed in advance.

What project pricing accounts for

  • Inventory volume

  • SKU mix

  • Furniture type

  • Assembly complexity

  • Warehouse footprint

  • Access conditions

  • Site conditions

  • Project duration

  • Loading requirements

  • Crew size

  • Delivery sequence

  • Room and floor allocation

  • Required equipment

  • Travel and mobilization

  • Insurance and project requirements

Standard FF&E and hotel baseline rate card

Standardized baseline rates for defined hotel and FF&E scopes, published so a project team can build a preliminary budget before contacting anyone.

ServiceBaseline rateNotes
Decommissioning labour$350 per roomRemoval of existing guest-room furniture from the room.
Disposal and hauling$170 per roomHauling and disposal of the decommissioned contents.
Combined decommissioning + disposal$520 per roomDecommissioning and disposal quoted together.
20' container receiving$375 per containerStandard receiving of a 20-foot container.
40' container receiving$750 per containerStandard receiving of a 40-foot container.
53' trailer receiving$900 per trailerStandard receiving of a 53-foot trailer.
Skid receiving$10 per skidStandard receiving of palletized inbound freight.
Warehousing$2.30 per sq. ft. / monthBaseline project-storage rate, billed on occupied footprint per month. Dedicated, out-of-market or project-specific facilities may be quoted according to the selected facility, market, term and project requirements.
Pick, label, load and standard 20' truck delivery run$615 per runOne prepared and delivered load to the installation site.
Hotel-room FF&E installation$750 per roomInstallation of a standard guest-room FF&E package.
Enhanced receiving / quality control$35 per labour-hourOpen-box inspection; the one hourly line in this rate card.

On the $2.30 warehousing rate: That is the baseline project-storage rate. Dedicated, out-of-market or project-specific facilities may be quoted according to the selected facility, market, term and project requirements, and the basis is confirmed in the project quotation before any capacity is committed.

How to read these rates

These are standardized baseline rates for defined hotel and FF&E scopes and are not universal quotations. Final project pricing may vary based on:

  • Market and location
  • Project size
  • Access conditions
  • Storage and facility requirements
  • Insurance requirements
  • Travel and mobilization
  • Equipment
  • Project-specific handling
  • Scheduling
  • Unusual scope
  • Waste and recycling requirements
  • Specialty pieces

All amounts are in Canadian dollars and are exclusive of applicable taxes. A project quotation confirms the rates, inclusions and any project-specific conditions that apply.

Minimum charges, travel and mobilization

Because normal FF&E installation and logistics projects are quoted flat-rate, any minimum mobilization requirement is incorporated into the project quotation rather than applied as a separate hourly minimum.

For out-of-market projects, applicable costs should be identified in the flat-rate proposal upfront rather than appearing unexpectedly during the project:

  • Travel
  • Accommodation
  • Transportation
  • Mobilization
  • Specialized equipment
  • Facility costs

Data-driven estimating, not a guess with a crew attached

A defined project is priced from measurable inputs and historical production data rather than an hourly rate and an optimistic assumption.

Estimating an FF&E program means answering a production question: how many rooms, units or square feet can a crew of a given size complete per shift under these access and assembly conditions. That question has a measurable answer once you have run comparable work.

Where a project provides a DSR — a detailed scope of requirements, sometimes issued as a project matrix listing quantities by room or area — it is used directly as an estimating input. Where no DSR exists, the same information is reconstructed from inventory lists, floor plans and packing slips.

Historical operational data allows defined projects to be priced using known production benchmarks rather than simply dispatching an hourly crew and allowing labour charges to accumulate without a clear ceiling.

Proprietary software. Leaner operations.

Next Movement and WarePulse were built internally to automate and streamline workflows that a conventional moving and transport operation handles manually.

Both platforms were developed in-house rather than licensed, which means the workflow follows the operation instead of the operation bending to fit generic software. Dispatch, administration, warehouse operations, inventory, reporting and project coordination run through systems designed for exactly this work.

Next Movement is independently operated and uses that technology to remove administrative layers rather than staff around them. On an FF&E program the practical effect is that the same people who receive, store and install the merchandise are working from one live record, so coordination is a system behaviour instead of a standing meeting.

What the software actually removes

Each of these is administrative work that a conventional operation absorbs with headcount and that Next Movement and WarePulse absorb in software instead.

  • Manual administration across dispatch, project and warehouse work
  • Automated dispatch workflows instead of phone-and-spreadsheet assignment
  • Duplicate data entry between receiving, inventory, delivery and reporting
  • Inventory guesswork, replaced by live quantities, locations, holds and allocation
  • Non-standard warehouse tasks, replaced by the same guided steps on every project
  • Reporting overhead, because status is read from the record rather than assembled for it
  • Coordination overhead between receiving, storage, delivery and installation

What that means for a project quotation

This leaner administrative structure contributes to competitive project pricing without reducing project controls, inventory documentation, warehouse visibility, operational accountability or field scalability. The saving comes out of overhead, not out of the controls a commercial project is buying.

What the leaner structure does not give up

  • Project controls
  • Inventory documentation
  • Warehouse visibility
  • Operational accountability
  • Field scalability

Where Next Movement works

Two different service levels, because a single installer request and a multi-phase hotel program are not the same logistics problem.

Smaller-scope projects and service calls

The current primary local service area is the Greater Montreal Area. Single-installer requests, service calls, warranty replacements and small punch-list visits are handled here, subject to availability.

Small service-call work is not offered on a national basis. If you need one installer in another market, ask and it will be answered honestly rather than accepted and subcontracted blindly.

Large FF&E, commercial and multi-phase projects

Large FF&E, commercial and multi-phase programs can be coordinated throughout major Canadian cities and their surrounding markets, using the same receiving, warehousing, inventory and installation chain described on this page.

Project-specific travel and mobilization for out-of-market work is quoted upfront in the flat-rate proposal.

Markets coordinated for project work

  • Montreal
  • Toronto
  • Vancouver
  • Calgary
  • Ottawa - Gatineau
  • Quebec City
  • Winnipeg
  • Edmonton
  • Halifax
  • Hamilton

Insurance, scheduling and confidentiality

The three questions that usually decide whether a commercial project team is comfortable proceeding.

Insurance and WSIB documentation

Next Movement maintains commercial insurance and can coordinate certificates of insurance and project-specific insurance requirements before mobilization.

  • Certificates of insurance coordinated before mobilization
  • Project-specific insurance requirements reviewed during onboarding
  • Applicable WSIB documentation or clearances for crews assigned to Ontario projects can be addressed as required during project onboarding
  • Coverage details and limits confirmed in the applicable project documentation

Scheduling and rescheduling

Construction schedules move. The planning question is what has already been committed when they do.

  • Small local assignments may require less advance planning and are subject to availability
  • Major FF&E programs should ideally be coordinated well in advance so labour, warehouse capacity, transport and sequencing can be reserved
  • On active large projects, day, night and weekend work can be supported where required and planned
  • Schedule changes are accommodated where resources allow
  • Cancellation and rescheduling terms are project-specific and provided in the applicable quotation, particularly where labour, trucks, travel, equipment, facilities or third parties have already been committed

Confidentiality and NDAs

We do not disclose non-public customer information, project documentation or site media without authorization, and we apply the same confidentiality standards to new clients.

  • NDAs respected and executed where required
  • Client privacy and project confidentiality maintained
  • Site-photography restrictions respected on site
  • Non-public client information not used in marketing or references
  • Project documentation shared only with authorized project contacts

Next Movement FF&E Partner Program

A standardized operating relationship for repeat commercial work

The Partner Program is not a discount tier or a membership level. It is a way of writing down how your projects are run so the second project does not start from zero.

Most of the cost and friction in a first FF&E project is agreement cost: deciding how merchandise is received, what gets inspected, how exceptions are reported, who authorizes a release, how crews present on site and what documentation the client needs. Once that is settled, it should not have to be settled again.

The Partner Program captures those decisions as a reusable project profile. New projects inherit the agreed procedures, the documentation requirements and the operating standards already established with your team.

What a partnership standardizes

  • Standardized client onboarding
  • Agreed receiving procedures
  • Client-specific quality-control instructions
  • Client-specific OS&D procedures
  • WarePulse portal access
  • Reusable project profiles
  • Recurring documentation requirements
  • Insurance and certificate-of-insurance documentation requirements
  • Preferred branded or neutral crew presentation
  • Warehouse-capacity planning for recurring project sizes
  • Facility-readiness requirements carried into every project
  • Preferred project warehouse specifications
  • Client facility-review requirements agreed once
  • Room, floor and SKU allocation conventions
  • WarePulse project configuration reused across projects
  • Outbound sequencing conventions
  • Site-conduct standards
  • Reusable installation standards
  • Named operational coordination
  • Flat-rate project proposals
  • Deficiency and exception workflows
  • Repeatable project templates
  1. Introductory discussion

    We review the kind of work you run, the markets involved, the volume you expect and the documentation your side of the project needs.

  2. Operating profile

    Receiving, inspection depth, OS&D handling, warehouse-readiness and facility-review expectations, preferred warehouse specifications, allocation and outbound sequencing conventions, crew presentation, site conduct and reporting are written down as your standing profile.

  3. Onboarding

    Insurance and certificate requirements, portal access and named coordination are set up once rather than per project.

  4. Project execution

    Each new project inherits the profile, is quoted flat-rate against its own scope, and runs against the standards already agreed.

Partnership is established through discussion and is not automatic. Fit depends on the type of work, the markets involved and available capacity.

Vendor due diligence

FF&E Vendor Qualification Pack

Evaluating Next Movement for a commercial project? Request our FF&E vendor qualification information covering warehouse readiness, receiving and QC controls, OS&D, WarePulse, insurance documentation and project onboarding.

Procurement teams normally have to assemble this by email, one question at a time. The qualification pack exists so a design firm, developer, general contractor, hotel group or ownership group can assess Next Movement through its actual operating controls instead of a sales call.

What the qualification information covers

  • FF&E capability overview and service scope
  • Warehouse readiness and facility-selection process
  • Receiving controls and documentation
  • Standard receiving versus enhanced quality control
  • OS&D exception and disposition process
  • WarePulse inventory visibility and client portal access
  • High-value and specialty handling approach
  • Insurance and certificate-of-insurance availability
  • Applicable WSIB documentation availability
  • Site-conduct and crew presentation standards
  • Project intake requirements and onboarding steps
  • Confidentiality and NDA standards
Request the FF&E Vendor Qualification Pack

The request goes through the FF&E project intake form on this page with the inquiry type set to vendor qualification, so it reaches the operations team with your project context attached. Materials are prepared for the request rather than published as a generic download.

Commercial warehousing outside an FF&E program

FF&E programs get the deeper receiving, quality-control and installation chain documented on this page. For commercial warehousing outside an FF&E scope — pallets, cross-docking, overflow capacity, general project staging — there is a dedicated service.

FF&E logistics questions, answered

The questions commercial project teams normally have to ask by email before they can shortlist a logistics partner.

What does FF&E logistics include?

FF&E logistics covers inbound freight and container receiving, reconciliation against packing lists and purchase orders, condition documentation and quality control, warehousing, inventory control in WarePulse, room and floor allocation, sequenced delivery, white-glove installation, deficiency management and packaging removal. Next Movement runs that chain as one coordinated operation.

Do you work with interior designers and developers?

Yes. Interior designers, design firms, developers, general contractors, hotel groups, hospitality renovation teams, procurement firms, property and project managers, and commercial fit-out teams are the core audiences for this service. Placement can be executed against renders, floor plans and furniture schedules supplied by the design team.

Do you provide white-glove FF&E installation?

Yes. A standard installation scope covers unloading, unpacking, furniture assembly, placement according to plans or designer direction, beds, desks, casegoods, seating, standard artwork, standard mirrors, accessories and miscellaneous non-licensed fixtures, final positioning, packaging removal and punch-list support.

Can you receive furniture before the installation date?

Yes. Receiving merchandise in advance and warehousing it until the site is ready is a normal part of an FF&E program. Goods can be received from containers, trailers and skids, recorded into WarePulse, stored for the project period, then picked and delivered against the installation sequence.

Do you inspect incoming furniture for damage?

Standard receiving documents external condition and photographs visible irregularities or damage. Enhanced receiving and quality control goes further: cartons are opened and the merchandise itself is visually inspected within the approved inspection scope.

What is the difference between standard receiving and enhanced QC?

Standard receiving verifies the shipment against its reference, reconciles quantities against the packing list and purchase-order information, identifies SKU and article numbers, documents external condition, photographs visible irregularities, records merchandise into WarePulse, assigns a warehouse location and completes putaway. Enhanced QC additionally opens cartons, visually inspects the merchandise, identifies visible finish defects and damage, checks for obvious missing components where practical, photographs findings, documents deficiencies, repacks where appropriate, places affected goods on hold and escalates for client disposition.

How much does enhanced FF&E QC cost?

Enhanced receiving and quality control is $35 per labour-hour. That is the customer-facing rate. It is billed hourly because inspection time depends on what is actually inside the cartons, and it is the one exception to the flat-rate project pricing used for defined FF&E scopes.

What is OS&D?

OS&D stands for overages, shortages and damages. It is the umbrella term for receiving exceptions: more merchandise than expected, fewer pieces than the paperwork states, visible damage, concealed damage found on opening, incorrect merchandise, documentation discrepancies and other exceptions that prevent a clean receipt.

How are damaged or deficient items handled?

The exception is documented, photographed and recorded against the inventory record. Affected merchandise can be isolated or placed on hold so it does not accidentally proceed to outbound delivery or installation before the exception is resolved. The project contact is notified with the documentation, and the merchandise moves only on an authorized disposition. Documentation supports a claim but does not guarantee its approval or the assignment of liability.

Can inventory be organized by SKU, floor, room or project phase?

Yes. Inventory in WarePulse carries SKU and article references, quantities, warehouse locations and allocation to room, floor, unit or project phase, so a delivery run can be built to match the sequence the installation crew will actually work in.

Can clients view their warehouse inventory?

Yes. WarePulse includes client-facing surfaces — a customer inventory portal showing stock, allocation and available units, and a control tower showing order visibility and warehouse service status — so a project team can see its own inventory without being given access to the internal console.

Can you handle expensive or designer furniture?

Yes. High-value and designer FF&E is handled under project-specific instructions, which can include additional condition documentation, protective handling requirements, designated storage or segregation, written handling instructions attached to the inventory record, controlled release and hold workflows, project-specific insurance review and declared-value considerations where applicable.

Can crews wear unbranded professional attire?

Yes. Crews can arrive Next Movement branded, or professionally dressed in neutral, unbranded attire, depending on the project or client requirement. Unbranded presentation is useful when the crew is expected to operate as a neutral extension of the design or project team, such as on client-facing reveals and model suites.

Do installers bring tools?

Yes. Crews bring standard professional installation tools and equipment for the approved scope of work. Manufacturer-specific or proprietary brackets, hardware and components should accompany the merchandise; where a proprietary component is missing, it is documented and escalated rather than substituting or modifying high-value furniture without authorization.

How do you protect finished floors and walls?

Through floor protection on delivery and installation routes, protective runners where appropriate, padding and moving blankets, door and corner protection, furniture protection during staging and placement, careful work around finished millwork, and documentation of sensitive or pre-existing conditions where appropriate. If a site condition creates a meaningful risk of damage, the crew escalates it rather than improvising to maintain production.

Do you remove packaging and debris?

Yes. Packaging consolidation and removal is part of a standard installation scope, so a room or floor is left in the condition the schedule requires. Volume-heavy disposal, recycling requirements or municipal restrictions are identified in the project quotation.

Can you provide one installer or a large crew?

Both. Crew scale runs from a single installer for a service call, to a small crew for a floor or a day block, to multiple coordinated crews working areas in parallel, to large multi-shift project teams for a full-property program. Single-installer service calls are currently a Greater Montreal Area service and are subject to availability.

Can you support phased, night or weekend installations?

Yes, where required and scheduled. On active large projects, day, night and weekend work can be supported, crews can be coordinated across phases, and additional resources can be reserved against project milestones. Labour for major programs is planned in advance rather than assembled on the day.

Do you work outside Montreal?

Yes for large FF&E, commercial and multi-phase projects, which can be coordinated throughout major Canadian cities and their surrounding markets. Smaller-scope projects and service calls are currently focused on the Greater Montreal Area. Travel and mobilization for out-of-market project work is quoted upfront.

Do you work in the GTA?

Yes. Toronto and the surrounding Greater Toronto Area is one of the markets where large FF&E and commercial project work is coordinated. Applicable WSIB documentation or clearances for crews assigned to Ontario projects can be addressed as required during project onboarding.

Can you secure dedicated warehouse capacity for a major project?

Yes. Next Movement provides warehousing and storage as part of its FF&E operations. For major programs that require substantial dedicated contiguous space — roughly 8,000 to 25,000+ sq. ft. for a limited project period — additional project-specific capacity can be selected against the project’s square footage, inbound schedule, inventory composition, storage duration, location, dock and equipment needs, access, operating hours, security, fire and building requirements, insurance requirements and proximity to the installation site.

Do you need to already own the warehouse used for my project?

Not necessarily. Large FF&E projects may require dedicated capacity beyond normal operating availability, and a permanent warehouse address is not the same thing as guaranteed project capacity, because a permanent warehouse may already be substantially occupied. Where appropriate, project-specific capacity can be selected and secured around the actual project requirements, and the selected facility then goes through the same warehouse-readiness controls before inbound merchandise is authorized.

Why not simply use existing warehouse space?

Often that is exactly what happens, and warehousing and storage are part of Next Movement’s FF&E operations. The reason a major program is treated differently is that residual availability may not match the contiguous footprint the program needs, major projects can require dedicated staging and receiving areas for months at a time, and project-specific capacity can simply be a better fit for the inbound schedule and the installation site. Planning the facility around the project is the practical way to give a large program the footprint it needs.

How do you know enough warehouse space will be available?

Space requirements are estimated from project data — inventory volume, required square footage, inbound volume, container and trailer schedule, storage duration, installation schedule, staging requirement, project phases and outbound intensity. Those requirements are defined before inbound merchandise is scheduled, dedicated capacity can be selected where the program requires it, and warehouse readiness is completed before receiving begins.

What happens before the first container arrives?

The project runs through warehouse readiness: capacity assessment, written facility requirements, capacity identification, facility and operating review, facility selection, client review where requested, WarePulse project setup, and preparation of the receiving, quality-control, hold and staging zones. Project inventory should not be directed to the selected facility until those readiness controls have been completed.

Can we review the warehouse before furniture is delivered?

For major projects, facility review can be incorporated into pre-mobilization planning where requested and subject to facility and security requirements. A visit can be arranged by appointment for an active or contracted project, and facility-review requirements can be recorded on the project intake form so they are built into the schedule rather than raised late. Unrestricted facility access is not offered.

Can clients visit project warehouse facilities?

Facility visits can be arranged by appointment for an active or contracted project, subject to facility and security requirements.

How can a procurement team perform vendor due diligence on Next Movement?

Request the FF&E Vendor Qualification Pack through the project intake form on this page, selecting “FF&E vendor qualification / due diligence” as the inquiry type. It covers the FF&E capability overview and service scope, the warehouse-readiness process, receiving controls, standard versus enhanced quality control, the OS&D process, WarePulse, high-value handling, insurance and certificate-of-insurance availability, applicable WSIB documentation availability, site-conduct and crew presentation standards, project intake requirements and confidentiality standards.

Do you bill hourly or flat-rate?

Defined FF&E projects are generally quoted on a flat-rate project basis rather than open-ended hourly billing. The exception is enhanced receiving and quality control, which is billed at $35 per labour-hour because inspection time depends on the contents of the shipment.

What are your standard FF&E rates?

Published baseline rates are: decommissioning labour $350 per room; disposal and hauling $170 per room; combined decommissioning and disposal $520 per room; 20-foot container receiving $375; 40-foot container receiving $750; 53-foot trailer receiving $900; skid receiving $10 per skid; warehousing $2.30 per sq. ft. per month; pick, label, load and standard 20-foot truck delivery run $615 per run; hotel-room FF&E installation $750 per room; and enhanced receiving and quality control $35 per labour-hour. These are standardized baseline rates for defined hotel and FF&E scopes and are not universal quotations.

How are travel and mobilization charged?

Because FF&E projects are quoted flat-rate, any minimum mobilization requirement is incorporated into the project quotation. For out-of-market projects, applicable travel, accommodation, transportation, mobilization, specialized equipment and facility costs should be identified in the flat-rate proposal upfront rather than appearing unexpectedly during the project.

How far in advance should an FF&E project be booked?

Major FF&E programs should ideally be coordinated well in advance so labour, warehouse capacity, transport and sequencing can be reserved. Small local assignments may require less advance planning and are subject to availability. The binding constraint on a large program is usually warehouse capacity and crew reservation, not truck availability.

How are schedule changes handled?

Construction schedules move, and Next Movement plans for that. Schedule changes are accommodated where resources allow. Cancellation and rescheduling terms are project-specific and provided in the applicable quotation, particularly where labour, trucks, travel, equipment, facilities or third parties have already been committed.

Can you provide insurance documentation?

Next Movement maintains commercial insurance and can coordinate certificates of insurance and project-specific insurance requirements before mobilization. Applicable WSIB documentation or clearances for crews assigned to Ontario projects can be addressed as required during project onboarding. Coverage details and limits are confirmed in the applicable project documentation.

How is client confidentiality handled?

We do not disclose non-public customer information, project documentation or site media without authorization, and we apply the same confidentiality standards to new clients. NDAs are respected and executed where required, and site-photography restrictions are respected on site.

How does someone request an FF&E project quote?

Use the FF&E project intake form on this page. It captures project location and type, approximate size, room count, target installation date and desired quality-control level, and an optional project-requirements step captures warehousing needs, estimated warehouse square footage, inbound container or trailer volume, storage duration, expected first inbound date, whether dedicated project capacity is required, whether a facility review is required before receiving, the installation-site area and the expected installation period. Documents such as furniture schedules, inventory lists, packing lists, room matrices, floor plans or RFP specifications can be sent by email after initial contact.

FF&E project intake

Request an FF&E project quote

The more of this you can answer, the closer the first reply gets to a real number instead of a list of questions. Anything you do not know yet can be left blank.

Who you are
The project

Warehousing, inbound volume, dedicated capacity, facility review, installation period and requirements. All optional — send what you have.

Do not attach documents here. Once we reply, you can send furniture schedules, inventory lists, packing lists, room matrices, floor plans or RFP specifications by email.

Your details are used to prepare a project response and are handled under our privacy policy. We do not share project information without authorization.

Start an FF&E project conversation

Send the scope you already have — room counts, inventory lists, floor plans, inbound schedule or an RFP — and you will get a project-specific answer rather than a brochure.
