FF&E Receiving: Standard Receiving vs. Open-Box Quality Control
Two inspection depths, two cost structures, and a decision that determines whether a defect is found on a dock or in a finished guest room.
Why receiving depth is a decision, not a default
Every FF&E shipment gets received. The real question is how deeply it gets looked at, and that question has a cost attached to it. Opening every carton on a 120-room package is a large number of labour-hours. Opening none of them means a finish defect on a case good is discovered when an installer unwraps it in a finished room, months after the carrier and the vendor have both moved on.
Treating this as a single blanket policy is what makes it expensive. Treated as a decision made per vendor, per SKU or per shipment, it becomes a manageable line in a project budget.
What standard receiving documents
Standard receiving is the baseline record every shipment gets. It answers three questions: what arrived, how much of it arrived, and what the outside of it looked like on arrival.
- The shipment is verified against its reference.
- Quantities are reconciled against the packing list and purchase-order information.
- SKU and article numbers are identified.
- External condition is documented.
- Visible irregularities or damage are photographed.
- Merchandise is recorded into the warehouse inventory system.
- A warehouse location is assigned.
- Putaway and staging are completed.
What open-box quality control adds
Enhanced receiving opens the carton and inspects the merchandise itself, within the inspection scope approved for the project. It is the only way concealed damage and finish defects surface before the piece is allocated to a room.
- Cartons are opened.

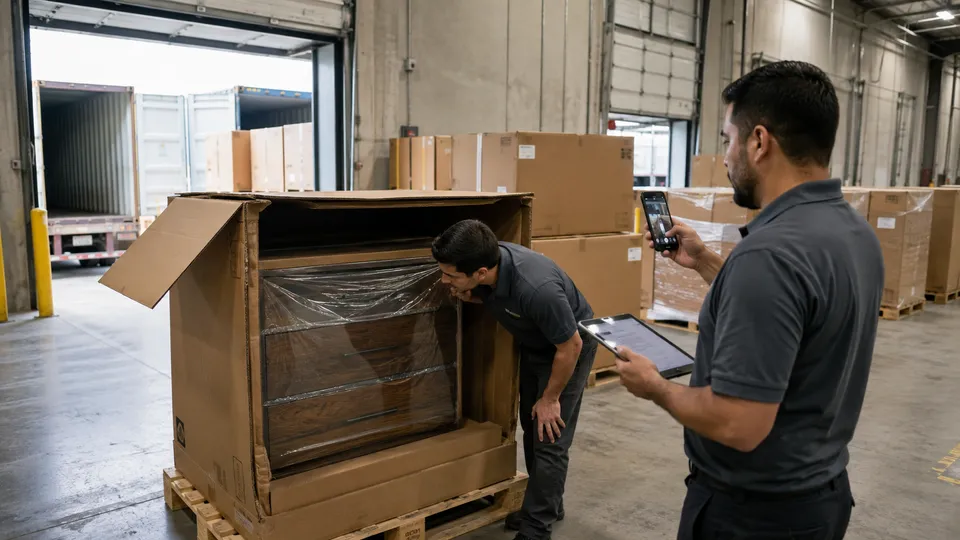

- The merchandise itself is visually inspected.
- Visible finish defects are identified.
- Visible damage is identified.
- Obvious missing components or hardware are checked for where practical.
- Findings are photographed and deficiencies documented.
- Goods are repacked where appropriate.
- Affected goods are placed on hold or quarantined and escalated for client disposition.
What it costs and why it is hourly
Next Movement bills enhanced receiving and quality control at $35 per labour-hour. That is the customer-facing rate, and it is deliberately the one hourly line in an otherwise flat-rate FF&E model.
Inspection time genuinely depends on what is inside the cartons. A carton of thirty identical accessories and a crated custom credenza do not take the same amount of time to inspect, and quoting them at the same fixed price would mean over-charging one and under-inspecting the other.
How to choose inspection depth
The practical pattern on most programs is selective, not uniform. Spend the inspection hours where the replacement cost and the lead time are highest.
- Full open-box inspection on vendors with a known quality history.
- Full open-box inspection on high-value or long-lead case goods and designer-specified pieces.
- Full open-box inspection on the first shipment from a new vendor, then reassess.
- Standard receiving on commodity items where replacement is fast and cheap.
- Escalate to open-box inspection mid-project if a vendor starts producing exceptions.
What quality control is not
Enhanced quality control is a visual inspection of the merchandise within an approved scope. It is not destructive testing, and it is not a manufacturer-grade quality certification. It will find a scratched veneer, a cracked leg, a wrong finish and a missing bracket. It will not certify structural load ratings or fabric composition.
Get Your Free Moving Checklist
Receive our comprehensive guide by email and SMS reminder so you don't forget anything during your move.
Deciding inspection depth in four steps
Run this before the first container is scheduled, not after it lands.
Rank by exposure
Sort the FF&E package by replacement cost and lead time. The top of that list gets open-box inspection.
Rank by vendor
Vendors with a history of finish issues or short-shipping earn open-box inspection regardless of item value.
Budget the hours
Estimate inspection hours for the selected scope at $35 per labour-hour and put the number in the project budget as its own line.
Write it into the scope
Record the inspection rule in the project profile so every shipment is handled the same way without re-deciding.
Frequently asked questions about FF&E Receiving: Standard Receiving vs. Open-Box Quality Control
How much does open-box FF&E quality control cost?
Enhanced receiving and quality control is billed at $35 per labour-hour. It is hourly because inspection time depends on what is inside the cartons.
Does standard receiving catch damage?
Standard receiving documents and photographs damage that is visible externally, on the carton or on exposed merchandise. Concealed damage inside a sealed carton is found by open-box inspection.
Can inspection depth differ by vendor within the same project?
Yes. Inspection depth can be selected by project, by vendor or by SKU, which is usually cheaper than applying full open-box inspection to every incoming piece.
What happens when an inspection finds a defect?
The exception is documented and photographed, recorded against the inventory record, and the affected merchandise is placed on hold so it does not proceed to delivery or installation before the client authorizes a disposition.
Plan your move next
Continue into the service, pricing, and local details that fit this move.
See also
Planning receiving for an FF&E program?
The FF&E logistics page sets out both receiving levels in full, alongside project warehousing, OS&D handling, installation scope and the published baseline rate card.
