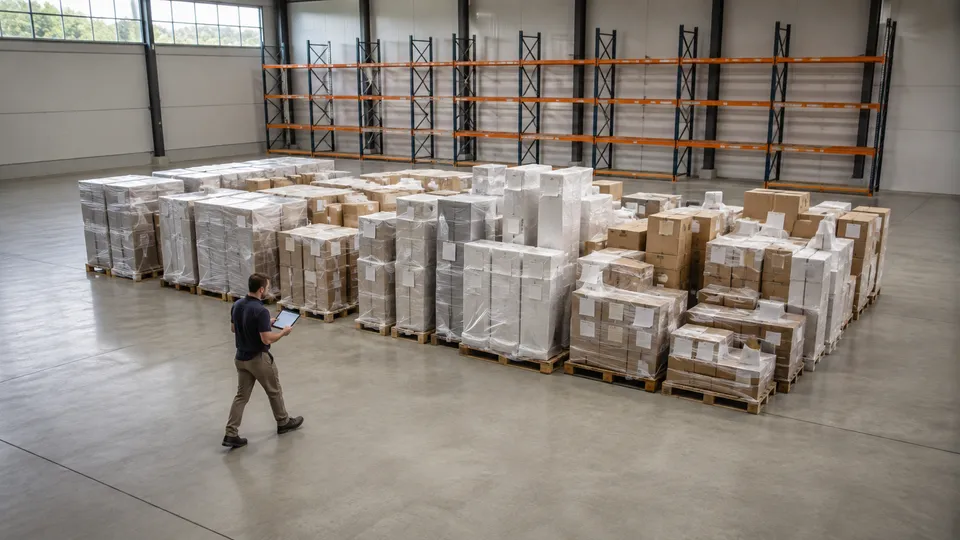

Project-Specific Warehousing vs. General 3PL Storage for Renovations
Two storage models built for different jobs. Choosing the wrong one is usually discovered at the first delivery run.
The two models
A general third-party logistics arrangement rents you capacity inside a shared facility that is running many clients at once. You get a rate per pallet or per square foot, standard receiving, and a place in a shared operation optimised for throughput.
A project-specific arrangement secures capacity around one contract for a finite period. Space is selected against what the project requires — footprint, contiguity, inbound schedule, dock and equipment needs, security, insurance and proximity to the installation site — rather than fitting the project into whatever is free.
Neither is better in the abstract. They are built for different jobs, and most FF&E projects are comfortably served by ongoing warehousing capacity without needing either extreme.
What a general 3PL is optimised for
Understanding what a shared facility is good at explains where it strains on a renovation.
- High turnover: stock in, stock out, measured in days rather than months.
- Uniform, rackable inventory with predictable dimensions.
- Order-level picking — a customer orders items, the warehouse ships items.
- Many clients sharing labour, equipment and dock time, which is what makes the rate competitive.
- Standard receiving against a purchase order, with exceptions as the unusual case.
What a renovation program actually needs
An FF&E program inverts most of those assumptions, which is why the fit can be poor at scale.
- Very low turnover: everything arrives over months and leaves over weeks.
- Awkward, often non-rackable inventory — headboards, wrapped casegoods, oversized mirrors.
- Room-level picking rather than order-level: a run is a floor, not a list of SKUs.
- A large contiguous block, because picking a room means pulling from across the whole package.
- Exceptions as a routine event, with holds that have to survive months of storage.
- A hard end date, after which the space is not needed at all.
Where the two models break
The mismatches show up in a predictable order.
- Fragmentation — shared capacity is allocated wherever it is free, so a large package ends up split, and every delivery run becomes a consolidation exercise first.
- Picking model — a facility built for order picking can usually be asked to pick by room, but it is not what the operation is shaped around, and the cost shows up in labour.
- Holds — quarantining a damaged piece for three months is unusual in a fast-turn facility and easy to lose track of.
- Peak inbound — six containers in a fortnight is a spike for a shared dock and a normal week for a project facility.
- The tail — you pay for shared capacity in a shape that assumes turnover, on inventory that does not turn over.
Comparing them directly
- Turnover — 3PL: high, by design. Project: near zero until installation starts.
- Contiguity — 3PL: wherever capacity is free. Project: selected as one block.
- Picking — 3PL: by order. Project: by room, floor or phase.
- Exception holds — 3PL: possible but atypical. Project: expected and designed for.
- Inbound peaks — 3PL: smoothed across clients. Project: planned around the container schedule.
- Commitment — 3PL: ongoing, cancel with notice. Project: fixed to the contract period.
- Best fit — 3PL: ongoing distribution and smaller FF&E scopes. Project: large renovations with a defined window.
How to choose
The decision usually resolves on four questions, and the answers are known before anyone quotes.
- How much contiguous space does the package need, and for how long? Roughly 8,000 to 25,000+ sq. ft. for a finite period points toward dedicated capacity.
- Is picking room-based? If a delivery run equals a floor, the facility needs to be shaped for that.
- How concentrated is the inbound schedule? Several containers inside a short window needs planned dock time.
- Does proximity to the installation site change the delivery plan? If shorter runs materially reduce cost and risk, location becomes a selection criterion rather than an accident.
How dedicated capacity gets secured
Where a project justifies it, capacity is sourced against the contract: required footprint and contiguity, the expected container and trailer schedule, inventory composition, storage duration, loading docks and material-handling equipment, access, security, fire and building requirements, insurance requirements, and proximity to the installation site.
This is ordinary warehousing economics rather than a special favour. Holding very large blocks of completely unused space indefinitely is inefficient, so the practical way to give a major program the contiguous footprint it needs is to plan the facility requirement around the actual contract and its duration. Facility visits can be arranged by appointment for an active or contracted project, subject to facility and security requirements.
What changes if the schedule slips
Renovation schedules move, and the two models absorb that differently. Shared capacity is generally easier to extend at the margin but harder to expand suddenly, because the space beside yours belongs to someone else. Dedicated capacity is committed for a period, so an extension is a commercial conversation rather than an operational one — but the footprint does not shrink or fragment underneath the project while that conversation happens.
Either way, storage duration should be measured from the expected first inbound date rather than the first installation date, with contingency for schedule movement built in from the start.
